PLUTO 2 LNG COMPRESSOR
Compressor Installation for a major energy company a major LNG project Project
PROJECT OVERVIEW
■ ■ ■
Mervin Cunningham from ALS was brought in as a consultant and as a jacking supervisor on the compressors. The Pluto Train 2 project is an expansion of the existing Pluto LNG facility near Karratha, Western Australia, designed to process gas from the Scarborough field with an LNG capacity of approximately 5 million tonnes per annum. A critical component of this expansion was the installation of heavy LNG compressors using advanced jacking technology.
The jack-down of 3600-tonne compressors represents one of the largest synchronous multi-point lifts in the LNG sector, enabling timely and precise installation of Train 2’s critical liquefaction equipment.
PROJECT DETAILS
■ ■ ■
Client: Woodside Energy
Location: Karratha, Western Australia
Sector: Oil & Gas (LNG)
Services: Climbing Jack-Up System, Heavy Lifting, Engineering, Project Management
Project Start: 04/02/2025 – Project End: 01/02/2026
SCOPE OF WORKS
■ ■ ■
1. Compressor Jacking Operations
Contractors and Technology:

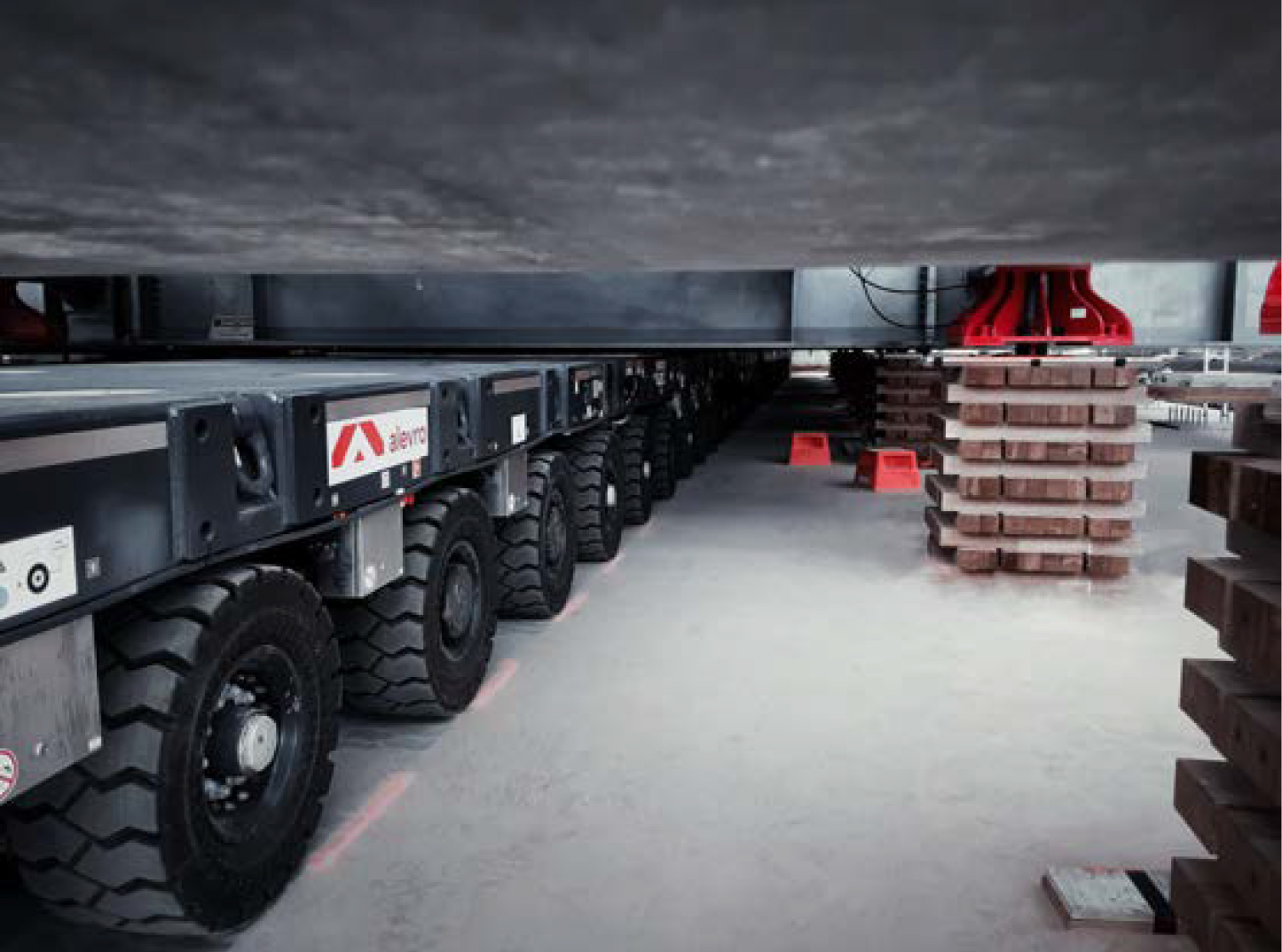

ALS assisted Alevro on the project, executed the heavy lift operation. Enerpac EVO synchronous jack-down system was employed, designed for 3600-tonne modules. The system included:

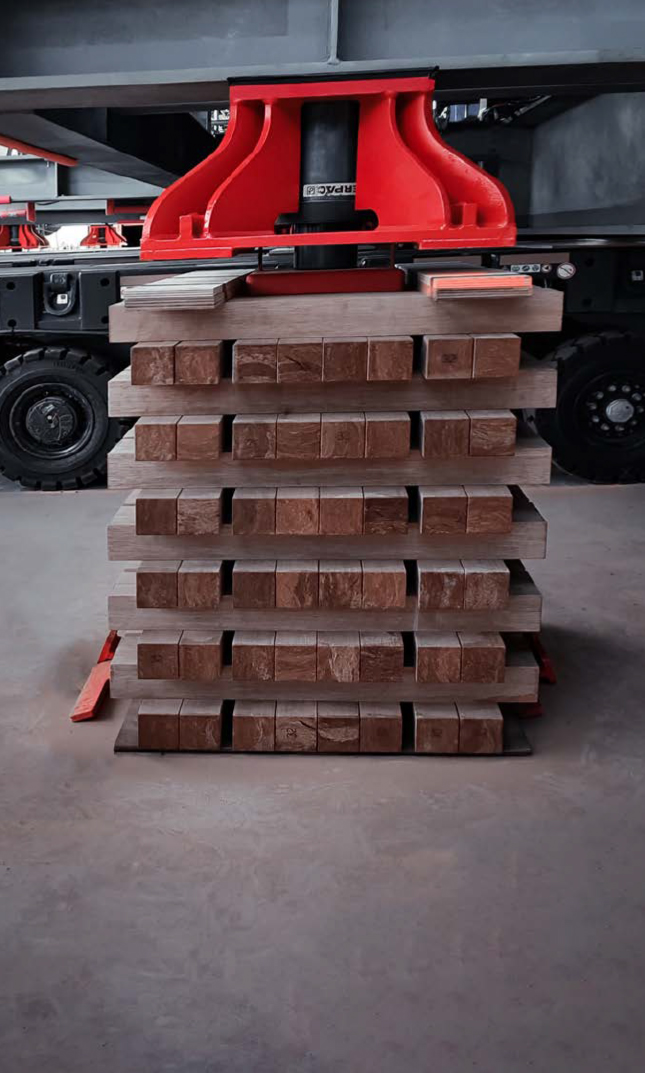

- 44 climbing jacks on 1.2-meter stacks with 500 mm climbing jack frames
- Two EVO hydraulic power packs controlling 24 jacks on 12 hydraulic lines
- Enerpac 250T jacks capable of precise load transfer
- Tilting mode for smooth alignment during load transfer from Self-Propelled Modular Transporters (SPMTs)
2. Compressor Module Characteristics:

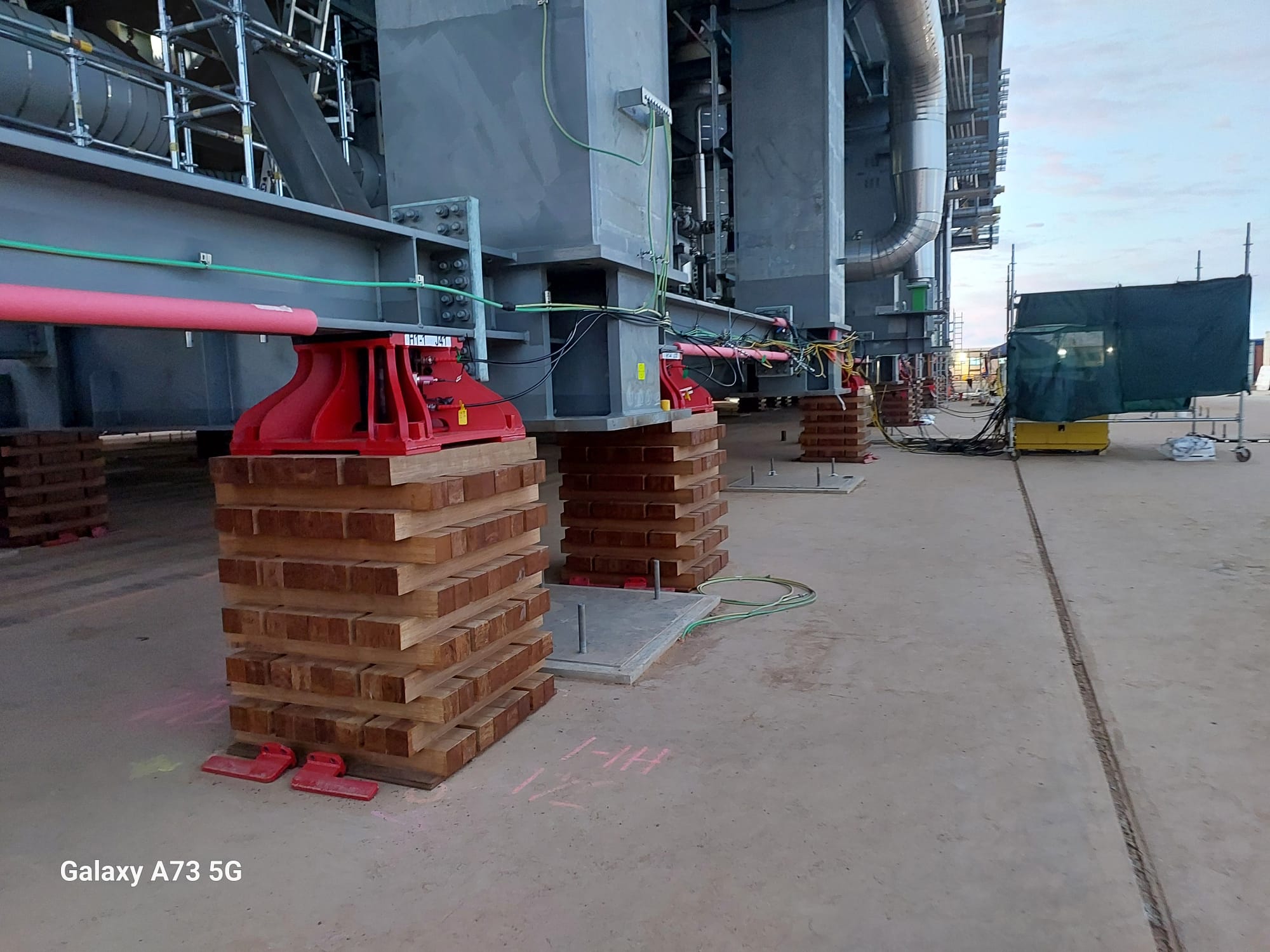

- Each compressor module weighed ~3600 tonnes
- Dimensions: 63 m long, 30 m wide, 30 m high

- Transported from the quayside using SPMTs with 168 axle lines and eight power packs

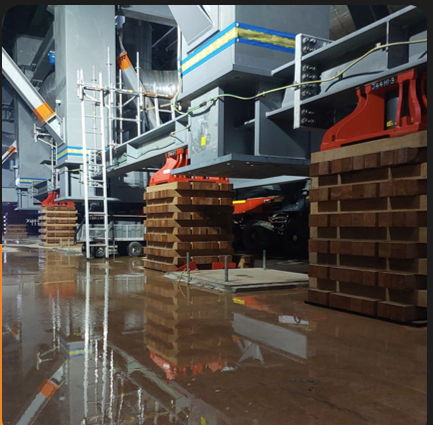

- Modules precisely positioned onto pre-prepared foundations
3. Operational Details:

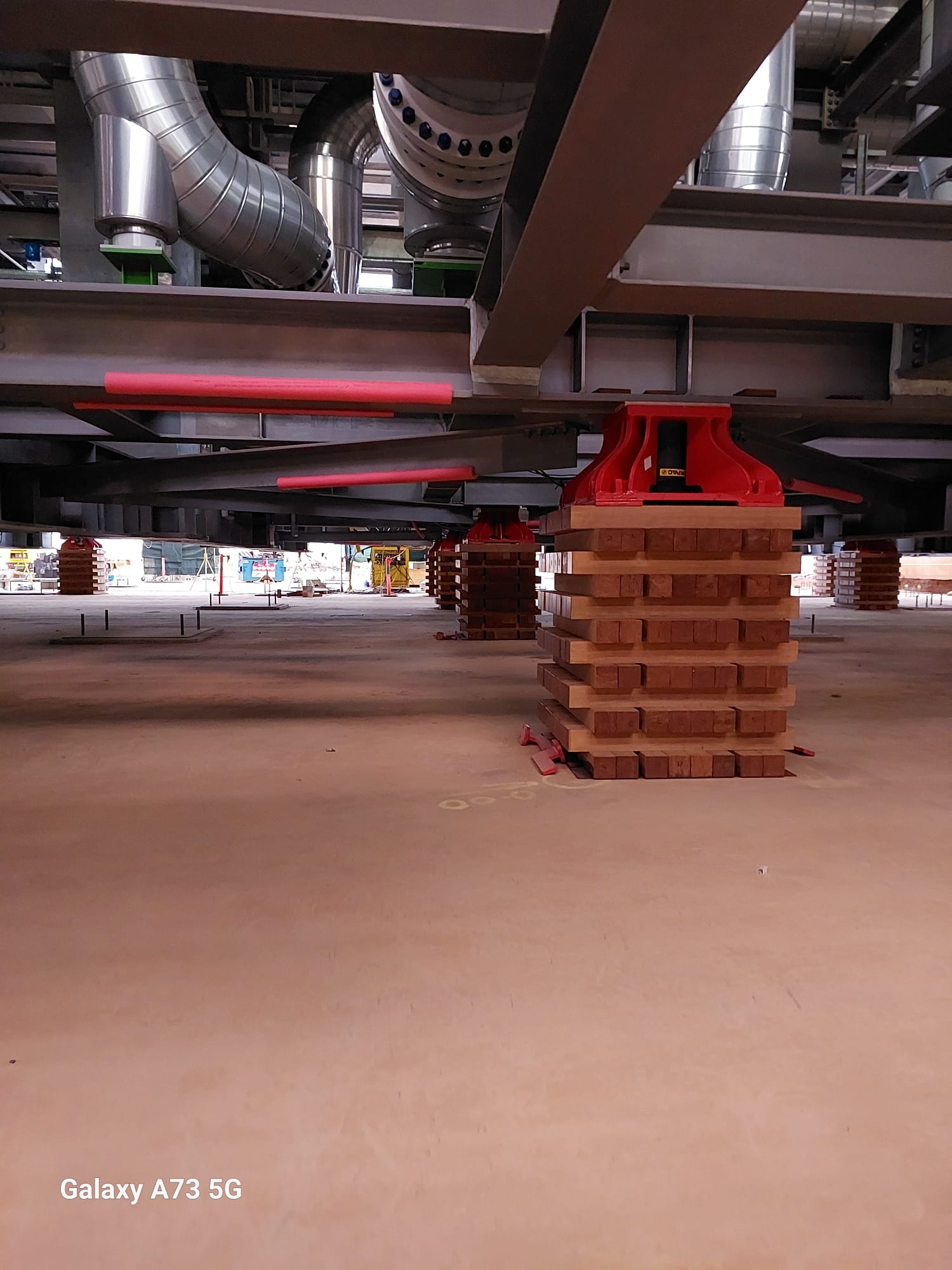

- Jacking involved transferring the module from SPMTs to climbing jacks
- Electrical power requirement for the hydraulic system was ~7.5 kW

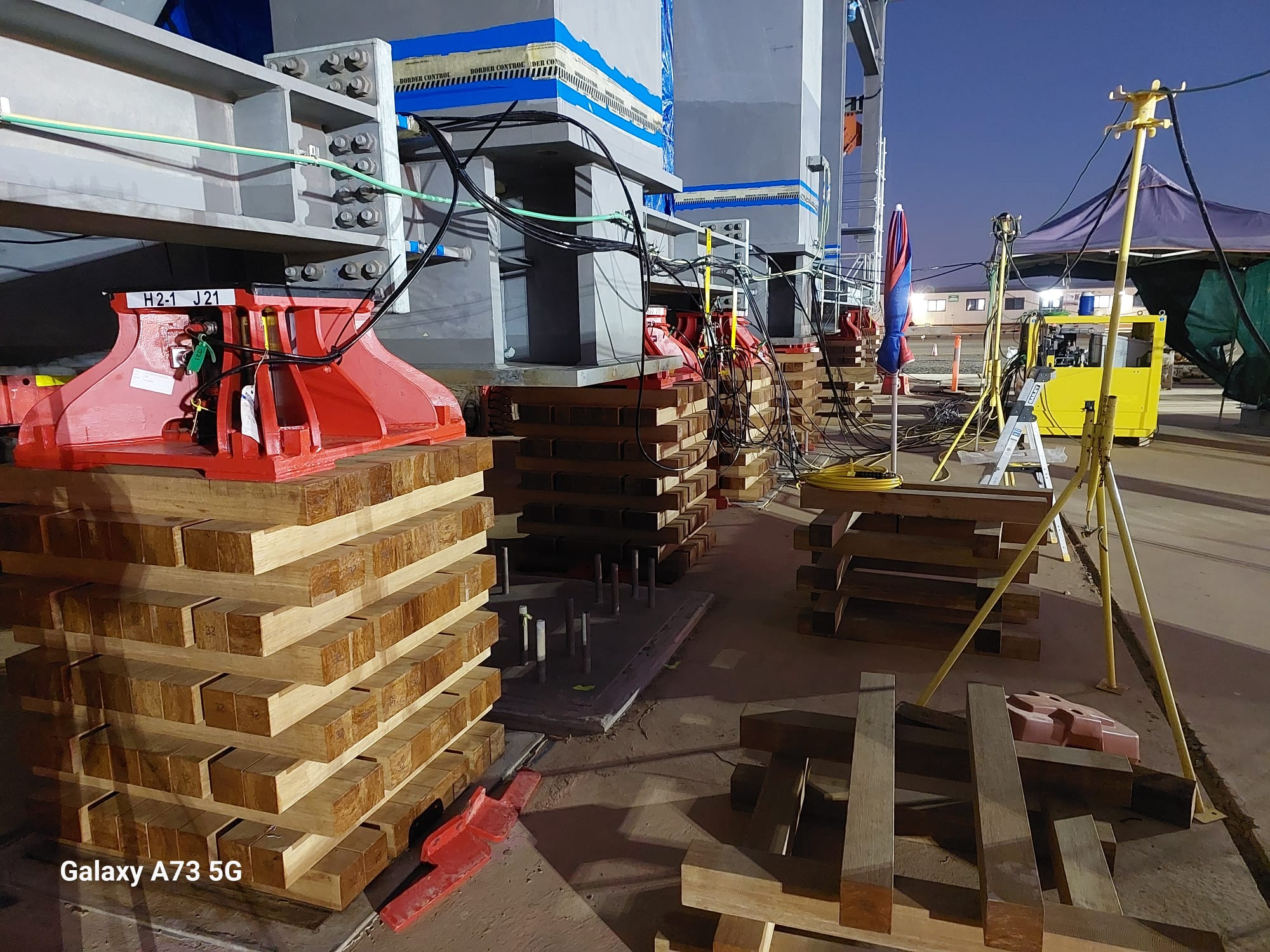

- Pre-planning ensured the operation avoided structural clashes via bespoke jacking frame design
- The process was recognized by the Crane Industry Council of Australia (CICA), winning awards for innovation
4. Project Scope:
ALS assisted with 3 modules weighing 3,600 tonnes each. Compressor modules were placed onto reinforced foundations embedded in concrete (~3600 m³ poured). Comprehensive safety planning ensured both module stability and personnel safety.
5. Significance:
The jack-down of 3600-tonne compressors represents one of the largest synchronous multi-point lifts in the LNG sector. It supports seamless processing of Scarborough gas to LNG, enhancing Western Australia’s energy exports.
